Save Time & Money with this Phoenix Office Fit-Out Checklist

  • Home
  • Save Time & Money with this Phoenix Office Fit-Out Checklist

Phoenix’s commercial real estate landscape is among the most dynamic in the world. From downtown to the suburbs thousands of businesses transform raw shell spaces into high-performing workplaces every year. Yet without a structured office fit-out checklist, even the most ambitious office renovation Phoenix project can spiral into budget overruns, authority rejections, and costly delays.

Structured Office Furniture Fit-Out Checklist

Office Fitout Office furniture Phoenix
Office furniture Phoenix

This authoritative guide developed with insights drawn from decades of commercial fit-out experience across the Phoenix Metro area walks you through every critical stage of the process: from initial briefing and authority approvals to MEP coordination, IT infrastructure, ergonomic workspace planning, and final handover. Whether you are a start-up fitting out 200 sq ft of co-working space or a multinational corporation executing a Category B commercial fit-out across three floors, this checklist is your blueprint.

Read every section carefully. Bookmark it, share it with your project team, and use it as a living reference document. By the time you reach the end and the CTA at the bottom, you will have the clarity and confidence to deliver your office setup in Phoenix metro area on time, on budget, and most importantly exactly as you envisioned.

1. Why a Structured Fit-Out Checklist Is Non-Negotiable in Phoenix

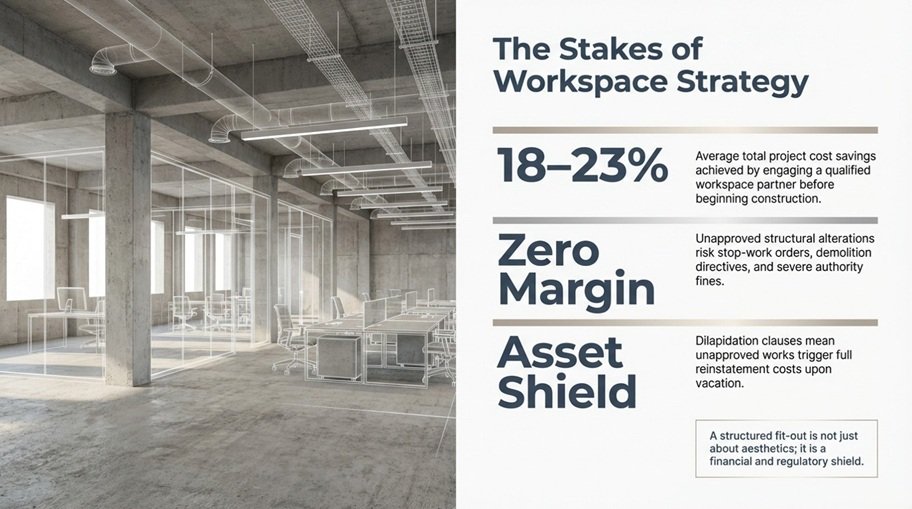

Workplace Strategy
Workplace Strategy Office furniture Phoenix

The Phoenix metro regulatory environment is precise and, in many cases, unique. An unapproved structural alteration can result in stop-work orders, demolition directives, and fines that dwarf the original fit-out budget.

Beyond compliance, structured planning directly influences your return on investment. Research by CBRE consistently shows that organizations that engage a qualified workspace planning from day one save an average of 18–23% on total project costs compared with those who begin construction before completing design and approval cycles.

A comprehensive office design checklist also protects the landlord relationship. Most Phoenix metro lease agreements include dilapidation clauses, meaning unapproved alterations can trigger full reinstatement costs upon vacation. Planning well from the outset preserves both your deposit and your reputation as a commercial tenant.

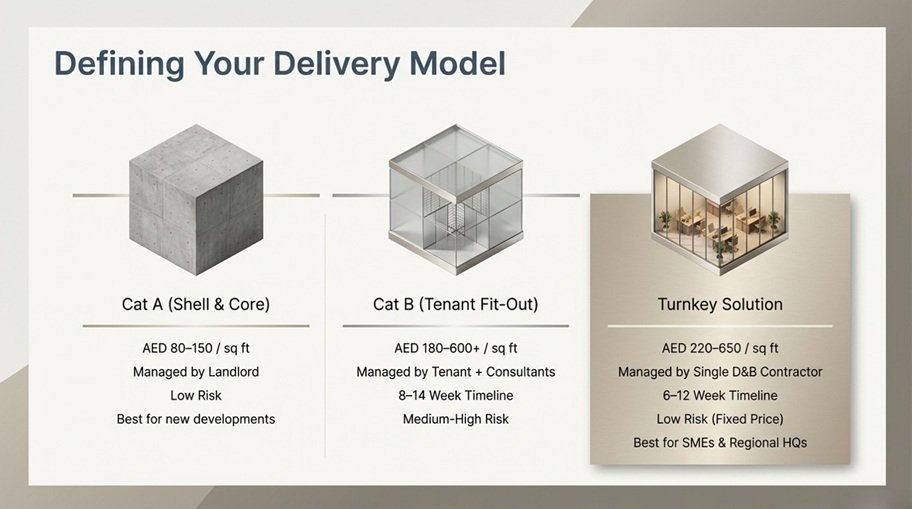

2. Understanding the Three Types of Office Fit-Out in Phoenix

Phoenix Office Shell, Buildout, Turn Key
Office Shell Buildout Turn Key

2.1 Category A (Shell & Core to Basic)

Category A fit-out transforms a raw shell-and-core unit into a lettable space. It typically includes raised access floors, suspended ceilings, basic mechanical and electrical distribution, fire detection systems, and toilet facilities. Landlords usually bear the cost of Category A works, or they may offer a fit-out contribution (FOC) incentive to attract quality tenants.

2.2 Category B (Tenant Fit-Out)

This is the primary focus of most businesses. Category B covers everything a company needs to be operational: partitioned meeting rooms, feature reception areas, branded design elements, custom joinery, specialist lighting, IT infrastructure, kitchen and breakout zones, and the selection of office furniture tailored to the brand identity. This is where the bulk of your office fit-out checklist applies.

2.3 Turnkey Office Solutions Phoenix

A growing preference among Phoenix metro businesses particularly SMEs and regional headquarters is the turnkey model. Here, a single design-and-build firm handles everything from conceptual design to furniture procurement, authority approvals, construction, IT cabling, and final handover. Turnkey office solutions Phoenix significantly reduce the project management burden on internal stakeholders and offer fixed-price certainty. Easy Spaces specializes in delivering turnkey office solutions across Phoenix metro, Las Vegas, and the southwest.

Fit-Out Type Comparison

3. The Master Office Fit-Out Checklist — Phase by Phase

Use this as a project framework. Each phase must be signed off before the next begins. Skipping phases is the single most common cause of cost overruns in commercial fit-out Phoenix projects.

Phoenix office furniture

Phase 1 — Discovery & Briefing (Weeks 1–2)

  • Define your head count, departmental structure, and 3–5 year growth projections
  • Establish a realistic budget envelope (construction, furniture, FF&E, IT, contingency)
  • Appoint a project lead internally to be the single point of contact
  • Conduct a lease review — identify landlord obligations, FOC allowance, reinstatement clauses
  • Survey the existing space: structural grid, slab-to-slab height, existing MEP distribution, loading capacity

Phase 2 — Design & Space Planning (Weeks 2–5)

  • Receive and evaluate concept design proposals
  • Agree on a design direction: open plan, cellular, hybrid agile, or branded executive
  • Complete a detailed space programmed per department (see Space Allocation Table below)
  • Confirm furniture strategy — standard ergonomic workstations vs. bespoke joinery vs. procurement of branded office furniture collections
  • Design sign-off on floor plans, elevations, material finishes, color palette, and lighting zones
  • Coordinate specialist disciplines: IT cabling, AV integration, access control, security CCTV
  • Agree MEP design with a qualified MEP consultant

Phase 3 — Authority Approvals (Weeks 4–8)

  • Submit for Phoenix Municipality (or relevant free-zone authority)
  • Obtain fit-out approval — fire suppression, smoke detection, emergency lighting
  • Approval for electrical load modifications and new panels
  • Telecom for structured cabling works
  • Landlord / Building Management NOC for works commencement
  • Structural NOC if any slab penetrations or load-bearing elements are altered
  • Apply for site hoardings and hoisting permits if heavy goods deliveries are planned

Phase 4 — Procurement & Pre-Construction (Weeks 5–9)

  • Award main contract — signed and insurance certificates in place
  • Issue purchase orders for long-lead items: glass partitions, bespoke joinery, imported office furniture (Easy Spaces can reduce to 2-4 weeks)
  • Order materials: ceiling tiles, raised floor, wall finishes, flooring, lighting fixtures
  • Mobilize site: hoarding, welfare facilities, material storage, site induction
  • Finalize MEP subcontractor scope and issue LOAs
  • Lock IT infrastructure design: server room location, structured cabling backbone, Wi-Fi AP positions

Phase 5 — Construction & Installation (Weeks 8–14)

  • Demolition and strip-out of redundant existing elements (if any)
  • First-fix MEP: conduit, trunking, ductwork, pipework, cable trays
  • Raised floor installation and/or screed works
  • Stud partitioning, drylining, and acoustic insulation
  • Suspended ceiling grid installation and integration with lighting and AC diffusers
  • Second-fix MEP: devices, light fittings, FCU connections, plumbing fixtures
  • Flooring: carpet tiles, LVT, polished concrete, or timber as per specification
  • Joinery installation: reception desks, storage walls, kitchen units, feature panels
  • Glazed partitions, manifestations, manifestation vinyl, and frameless door sets
  • Specialist AV, video-conferencing, and building management system (BMS) integration

Phase 6 — Furniture, IT & Fit-Out Completion (Weeks 12–16)

  • Deliver and install office furniture — workstations, chairs, collaborative seating, storage
  • Complete IT infrastructure: patch panel termination, switch configuration, Wi-Fi commissioning
  • Install signage, wayfinding, branded graphics, and manifestation
  • Commission all MEP systems with test & commissioning certificates
  • Civil inspection and fit-out completion certificate
  • Snagging: full joint inspection with contractor; issue snagging list
  • Rectify all snags; obtain building management practical completion sign-off
  • Hand over as-built drawings, O&M manuals, warranties, and spare parts

Project Timeline Breakdown — Typical Category B Fit-Out (1,000–2,000 Sq Ft)

4. Budgeting Your Office Fit-Out — Cost Benchmarks in AED

Office furniture and space Phoenix

Accurate budgeting is the foundation of a successful office renovation PHOENIX METRO project. Costs vary significantly based on zone, specification level, and the chosen delivery model. The following benchmarks are derived from live market data across Phoenix’s major commercial districts.

Budget Rule of Thumb:  For a mid-range Category B fit-out in Phoenix, plan for AED 280–420 per sq ft (construction only). Add AED 60–120 per sq ft for quality office furniture specification, and 10–12% for project management and contingency.

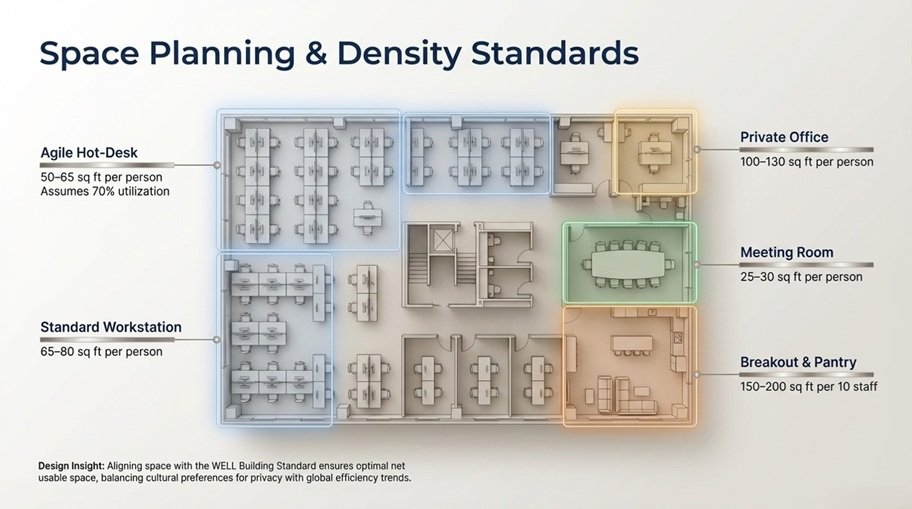

5. Space Allocation Standards Per Employee — Phoenix metro

International space benchmarks are shifting as agile working takes hold. The WELL Building Standard and BOMA guidelines recommend minimum net usable space per person. In the Phoenix Metro context, the following figures are widely adopted by leading workspace planning Phoenix consultants and reflect both local preferences (privacy, hierarchy, hospitality) and global efficiency trends.

Space planning Phoenix
Space planning Phoenix

6. MEP Considerations — Mechanical, Electrical & Plumbing for Office Fit-Outs

MEP works are the backbone of any functional workplace and routinely account for 30–45% of total construction costs in a commercial fit-out Phoenix project. Poor MEP coordination is the primary trigger for post-completion complaints acoustic failure, inadequate cooling, electrical outages, and plumbing leaks.

Phone Booth Phoenix

6.1 Mechanical — HVAC & Ventilation

Phoenix’s climate demands best-in-class cooling. Most commercial buildings are served by central chilled water systems, distributed via fan coil units (FCUs). Your fit-out must coordinate FCU positioning, fresh air quantities, and supply/return duct routing with the building services engineer.

  • Confirm chilled water flow rates allocated to your floor plate from the base building
  • Size FCUs for occupancy density — open-plan offices are typically 60–80 sq ft per ton of cooling
  • Incorporate dedicated fresh air units (FAUs) where base building supply is insufficient
  • Design for acoustic performance — NC-35 in open plan, NC-30 in meeting rooms
  • Install thermal comfort zones aligned to departmental / usage patterns

6.2 Electrical — Power, Lighting & Building Management

A typical Category B office requires 60–80W of connected load per sq ft (inclusive of HVAC). Confirm available load from the base building’s distribution board before finalizing your electrical design.

  • Design power distribution for dual-circuit workstations (power + data) plus dedicated UPS circuits
  • Ensure dedicated circuits for server room, AV systems, kitchen appliances
  • Install smart lighting controls to meet Phoenix Green Building Regulations
  • Incorporate metering at sub-panel level for energy monitoring and reporting
  • EV charging provisions if ground floor or basement parking is part of your lease

6.3 Plumbing & Drainage

Office fit-out plumbing primarily covers kitchen/pantry areas, toilet facilities, and any specialized facilities in the Phoenix Metro workplace design.

  • Design pantry drainage with grease traps if commercial-grade appliances are installed
  • Wudhu area specification: non-slip tiling, stainless steel fixtures, dedicated hot/cold supply
  • Inspect base building drain invert levels before routing new drainage — low slabs create significant constraints
  • Coordinate fire suppression (sprinkler) modifications with the approved contractor

7. IT Infrastructure Planning for Your Phoenix Office

Office space Phoenix Southeast Valley

A modern office setup Phoenix Metro demand that IT infrastructure is designed concurrently with architecture not retrofitted after construction. The cost of remediation (core-drilling finished floors, exposing ceilings) far exceeds early-stage investment in coordinated IT design.

7.1 Structured Cabling

  • Specify Cat6A (minimum) for all data outlets — future-proofs for 10G to the desktop
  • Design a centralized MDF / IDF strategy based on cable run lengths (max 90m horizontal)
  • Plan for 2 data ports + 1 power outlet per workstation as a baseline
  • Include dedicated cables for IP phones, VC cameras, door access readers, and CCTV

7.2 Server Room / IT Room Design

  • Minimum 2kW dedicated cooling (precision AC unit or CRAC) per rack
  • Raised floor (min 150mm) for cable management and under-floor cooling
  • UPS with minimum 15-minute runtime at full load
  • Dry pipe / inert gas fire suppression (NOT water sprinklers)
  • Biometric or card-access entry; CCTV with 30-day NVR retention

7.3 Wireless & AV

  • Conduct a wireless survey before AP placement — concrete columns and low-E glass cause significant dead spots in Phoenix
  • Specify enterprise-grade Wi-Fi 6E APs (e.g., Cisco Catalyst, Aruba, Juniper) for density and throughput
  • Integrate AV: 4K displays, Zoom/Teams certified codecs, room booking panels (Crestron, Extron, QSC)
  • IPTV / digital signage distribution for branded content in reception and breakout zones

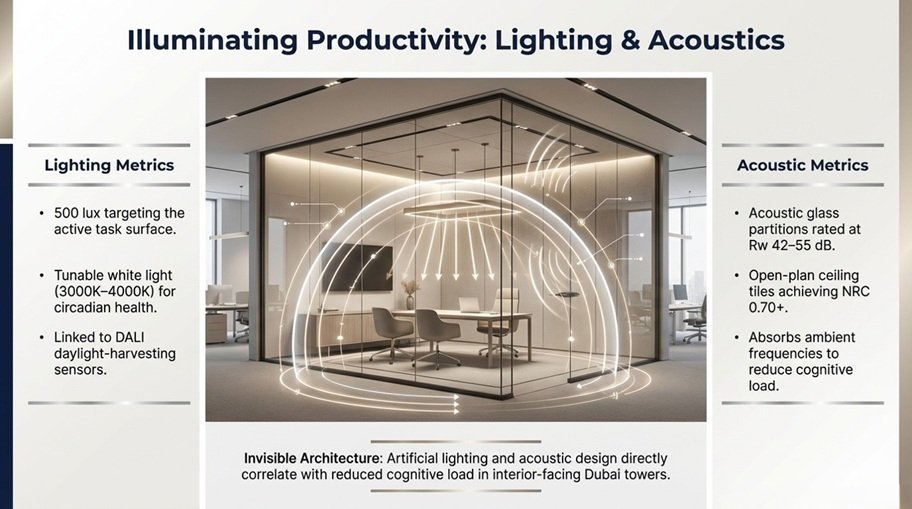

8. Lighting Design — A Critical Driver of Productivity and Wellbeing

Office space & Office furniture Phoenix

Research published in the Journal of Environmental Psychology and WELL Building Standard literature confirms a direct correlation between lighting quality and cognitive performance, mood, and circadian health. In Phoenix’s largely interior-facing offices particularly in towers where perimeter glazing is often limited by solar gain management artificial lighting design takes on heightened importance.

8.1 Illuminance Targets (Phoenix Green Building Regulations)

Smart Lighting Phoenix AZ
Smart Lighting Phoenix AZ

8.2 Smart Lighting Controls

  • Corret protocol for individual luminaire dimming and grouping
  • Daylight-linked photocell sensors at perimeter zones to harvest natural light
  • Occupancy sensors (PIR or ultrasonic) for automatic off/dim in unoccupied spaces
  • Tunable white (2700–6500K) in focus rooms and executive zones for circadian support
  • Emergency lighting: maintained / non-maintained as per Civil Defense specification

9. Workspace Ergonomics & Employee Wellbeing

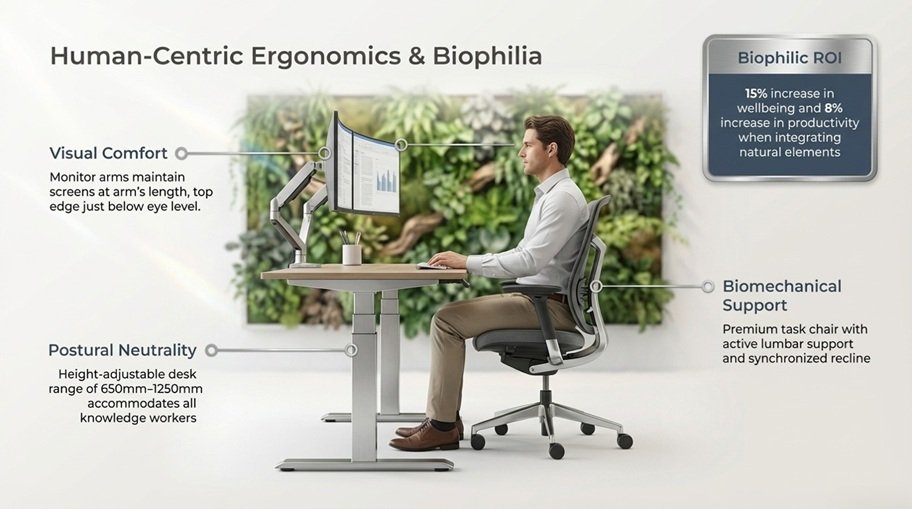

Ergonomic and Biophilia Phoenix AZ
Ergonomic and Biophilia Phoenix AZ

Ergonomics in the modern Phoenix Metro workplace transcends adjustable chairs. A truly ergonomic workspace planning Phoenix strategy addresses posture, acoustics, thermal comfort, visual comfort, cognitive load, and the social dynamics of the team holistically. Forward-thinking companies are aligning their office interior design Phoenix Metro with the WELL Building Standard (WELL v2) or the Fitwel framework.

9.1 Ergonomic Furniture Standards

Selecting the right office furniture is foundational. Premium office furniture Phoenix suppliers offer height-adjustable desks (sit-stand), lumbar-supportive seating, and monitor arms that enable true postural neutrality. The minimum ergonomic specification for a contemporary Phoenix Metro office should include:

  • Height-adjustable workstations— recommended for all knowledge workers
  • Ergonomic task chairs: adjustable seat height, lumbar support, armrests, recline mechanism (e.g., from established office furniture collections available through Easy Spaces)
  • Monitor arms: maintain screen at arm’s length, top of screen at or just below eye level
  • Under-desk cable management to eliminate floor-level trip hazards
  • Acoustic privacy screens between open-plan workstations

9.2 Acoustic Comfort

  • Target NRC 0.70+ for open-plan ceiling tiles (e.g., Ecophon, Armstrong Ultima)
  • Specify acoustic glass (Rw 42–55 dB) for meeting rooms — critical in buildings with hard surfaces
  • Install soft furnishings — fabric panels, lounge seating, rugs — in breakout zones
  • Phone booths / pods for focused calls without disturbing open-plan colleagues

9.3 Biophilic Design

Biophilic design incorporating natural elements into the workplace is proving to be one of the highest ROI investments in office interior design for the Phoenix Metro area. Studies by Human Spaces indicate a 15% increase in wellbeing and an 8% increase in productivity in offices with biophilic elements.

  • Living wall planters (moss walls or hydroponic vertical gardens) as reception focal points
  • Potted tropical plants at workstation clusters — low maintenance with Phoenix Metro climate compatibility
  • Natural material accents: timber veneer, stone, linen, rattan in breakout and lounge zones
  • Views of sky / water where possible — orient collaborative zones toward windows

10. Sustainability & Green Building Compliance in Phoenix

Office furniture Phoenix

Phoenix’s commitment to net-zero by Net Zero by 2050 Strategic Initiative is cascading directly into commercial fit-out regulation. Approved by the City Council in 2021, the Climate Action Plan focuses on reducing emissions through enhanced public transit, energy efficiency, and waste reduction

10.1 Key Sustainability Measures for Office Fit-Outs

  • LED lighting throughout minimum efficacy 100 lm/W
  • Low-VOC paints, adhesives, and sealants (CARB 2 or better)
  • Specify WELL-certified or Cradle-to-Cradle certified office furniture where budget allows
  • Carpet tiles with recycled content (min 25%) and Red List chemical-free binders
  • Water-efficient kitchen/pantry fixtures (WELS 3-star or equivalent)
  • Sub-metering for energy monitoring — enables reporting against Phoenix Carbon Abatement Strategy targets
  • Construction waste management plan — target 75% diversion from landfill (LEED CI standard)

10.2 Green Certifications Available in Phoenix

11. Selecting the Right Fit-Out Contractor in Phoenix

The contractor you appoint will make or break your project. Phoenix’s fit-out market is large, diverse, and uneven in quality. Use the following criteria to objectively evaluate and compare proposals from commercial fit-out Phoenix firms.

Office space Phoenix
Cost of DIY

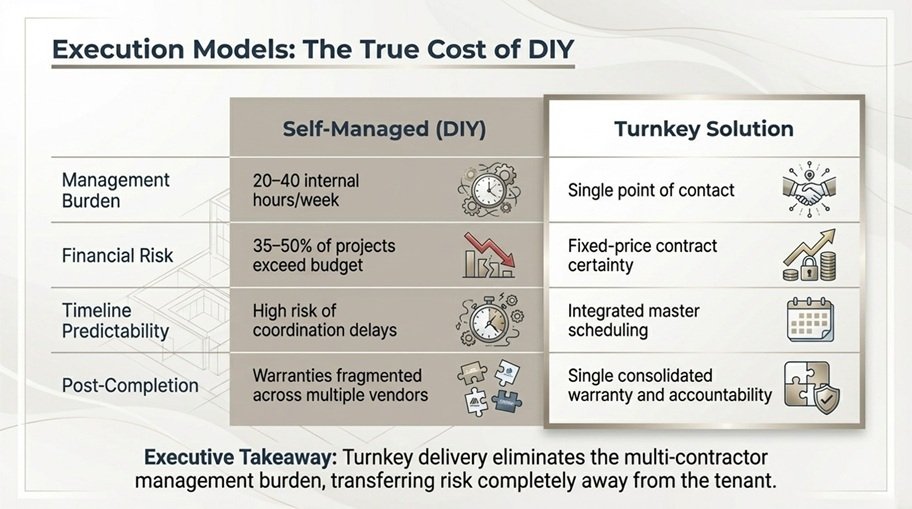

11.1 DIY Fit-Out vs. Turnkey Solution — Detailed Comparison

Cost of DIY
Cost of DIY

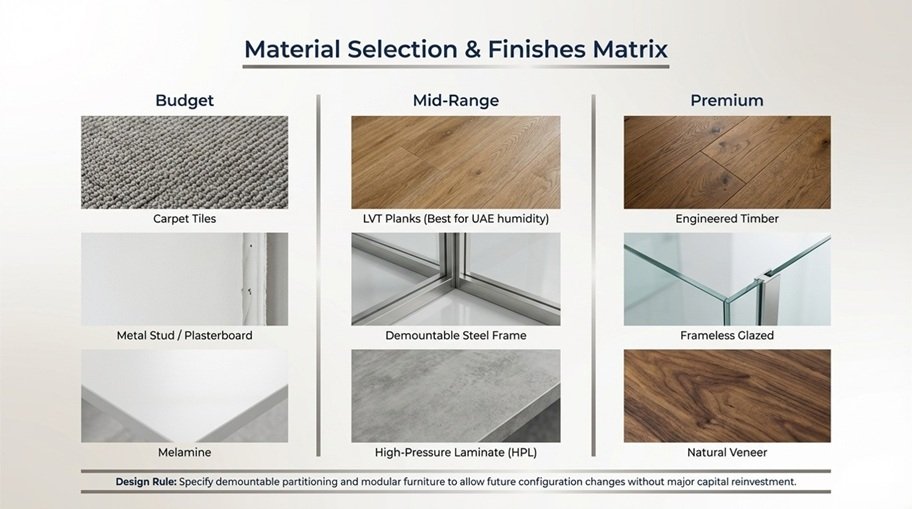

12. Materials Comparison — Making Informed Specification Decisions

Material selection and finishes Phoenix AZ
Material selection and finishes Phoenix AZ

13. Post-Installation Evaluation — Making Sure Your Fit-Out Delivers

A fit-out is not complete at handover. Leading organizations conduct a formal Post-Occupancy Evaluation (POE) 4–6 weeks after move-in to validate that the space performs as designed and to identify any ergonomic, environmental, or operational issues.

Post-Occupancy Evaluation Checklist

  • Thermal comfort survey: Are all zones hitting comfort zones? Are there hot spots near glazing?
  • Lighting assessment: Measure task illuminance with a calibrated lux meter against design targets
  • Acoustic measurement: Check NRC against spec; identify any HVAC noise complaints
  • IT performance: Wi-Fi throughput test per zone; VoIP call quality assessment
  • Furniture ergonomics: Are sit-stand desks being used? Is chair adjustment guidance provided?
  • Energy benchmarking: Compare kWh/sq ft to pre-fit-out baseline and DGBR targets
  • Occupancy vs. utilization: Are meeting rooms over/under-subscribed? Adjust booking policies
  • Staff satisfaction survey: Anonymous feedback on space, comfort, and collaboration
  • Snagging close-out: Confirm all DLP items formally resolved and signed off
  • Warranties log: Compile all product and systems warranties in a single managed register

Book an appointment here for a free consultation
